The work, one phase at a time
- The mural, 2013. Known: the scope, the wall and the client's own art. Unknown: whether there would ever be a second job. The question was whether the mural could be priced and delivered on its own terms, without a word about what might follow. It could. It produced a wall the client could stand in front of and a wall the city drove past every day. What it changed was the basis of the next conversation: the client was evaluating a finished piece of work, and the city had decided it liked a thing it had not been asked about.
- The retail store. Known: the company needed a store on the ground floor of a licensing office, selling the brand to people who came to see the building. The question was what a retail floor inside an occupied working building needs from the contractor, which is mostly hours, dust control and a schedule that respects the office upstairs. It produced the store, open for business and still open when the last release went out in 2017. What it changed was the relationship with Carson's planning staff, which began in earnest here, with ordinary reviews and inspections on an ordinary tenant build-out, the way a contractor's standing in a city is always built.
- Las Vegas, October 2014 to March 2015. A different entity and a different seat. Shelby American, the company that built the cars, moved to a new Las Vegas property; Tellus was not licensed in Nevada and served as owner's representative rather than builder. That engagement has its own report. It belongs on the map here because the foundation's trust in Tellus was one account, not two, and what happened in Nevada was part of why the Gardena work kept growing.
- The museum plan and the first phase of the Snake Pit, 2015 to 2016. Known: the foundation now wanted a plan for the whole building, and a VIP lounge, the Snake Pit, as the first stage of a museum. The question was what to build first inside a plan that did not yet have a museum's budget behind it. The answer was the pieces that let the foundation sell the idea to itself and its guests: models of the building, the future museum and the lounge, put on display, and temporary walls that showed how visitors would move through the space. By August 2016 the lounge itself was half built. Along the way Tellus managed the contracts and the construction on the foundation's behalf, and the foundation's own account of that period, in the release Tellus issued, is that the contract and construction management saved it a significant amount of money. The whole Carson facility program, the museum, the event space, the equipment and the retail store, ran in the range of 8 to 12 million dollars, a separate scope from the Las Vegas relocation. Our part of it was a construction management agreement covering a much smaller portion of that total, and nothing in this report should be read as that total being our fee or our revenue.
- The freeze, 2016. The City of Carson froze all new construction. The Shelby work sat in the middle of it. This is its own chapter below.
- The second phase of the Snake Pit, January 2017. Known: the lounge's finish scope, and the fact that the harder work was structural. The question was what had to be true before the client would let us cut into the part of the building that had been Carroll Shelby's own apartment. What had to be true was three finished phases. It produced the structural modifications, the roll-up door systems, the finish selections, and the bar built into the apartment, with a commercial kitchen, pool tables and indoor and outdoor event space around it, stocked with Shelby-branded beer and wine. The target was the annual Carroll Shelby Tribute and Car Show that spring, which the facility hosted and which had launched the 2016 Shelby Mustang the year before.
The freeze with no exception clause
In 2016 Carson placed a moratorium on all new construction. No exception clause, no application form, no variance procedure. Nobody else was getting out of it. The Snake Pit was half built, and the structural phase that would finish it was ahead of us.
The standard move is to treat a freeze as a legal object and argue with it through counsel: vested rights, prior approvals, the reach of the ordinance. That approach has a flaw the ordinance text hides. A freeze with no exception clause has not removed discretion; it has moved it from a form to a person, and that person's real constraint is not the ordinance, it is their own exposure if the call goes wrong later. A legal brief adds to that exposure. It asks the reviewer to take a position on the law, in writing, against a council that just said no to everyone.
So the packet was not a legal argument. It was built around the question the city was actually asking itself that year, which was how to become a place people drive to, and it answered with what Shelby would add to Carson: press, a name people already knew, an annual car show that filled the street, a destination on the route the city was trying to fill, in a city that was already betting on a racing facility and a stadium. It said so in the city's own terms. Behind that narrative went the record the city could check against its own files: the store it had inspected, the work it had watched go in, the press already printed about the project, and a mural it had decided it liked. Then it was papered completely, every claim with its backup, so that whoever said yes had a file to point to and nothing to take on our word.
I went in person. A packet through counsel leaves no one accountable in the room; a builder the staff already knew, standing there, is someone the city was approving rather than something. Tellus got one of the few exemptions the city granted, and the Snake Pit went on.
| The decision | The other way | What I did, and why |
|---|---|---|
| How to read the freeze | As law, to be argued with | As discretion that had moved to a person; a person needs a reason and a record, not a citation |
| What the ask was about | Our project and our schedule | Carson's own interest: press, a destination, a name on its street |
| What to lead with | A legal position on the ordinance | Work the city had already inspected, press already printed, a wall it already liked |
| How to paper it | A letter | Complete backup behind every claim, so the reviewer carried nothing on faith |
| Who carried it in | Counsel, by mail | Me, in the room |
The value-to-the-city packet
Read what the city is trying to hear that year, in its own documents and its own projects. Write the ask as what the project adds to that. Put the company's record in the city behind it, in the city's own files: delivered work, inspections passed, press already printed. Paper every claim with its backup. Bring it in yourself.
What it produced

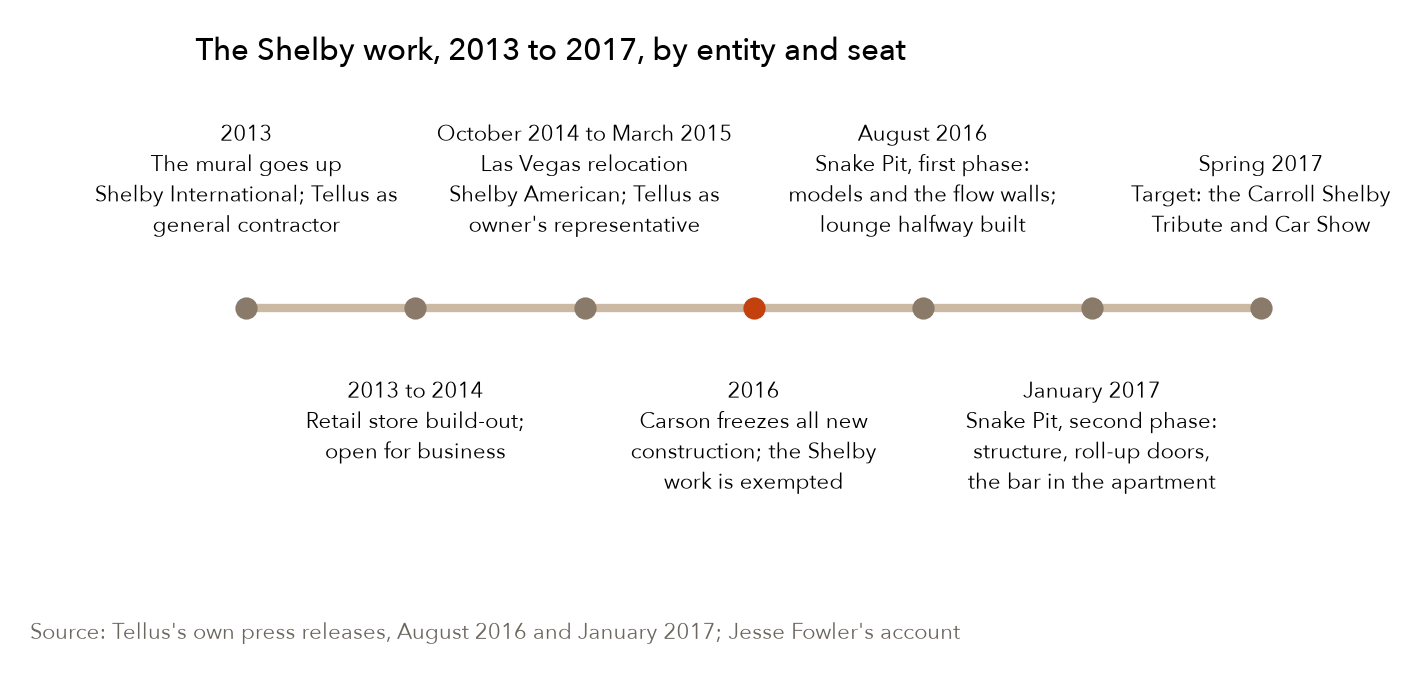

The phase map is the result. Four phases over four years for one entity, each one awarded on the last, and a separate engagement in another state for the sister company in the middle of them. No phase was sold ahead of the one before it, and the freeze sits in the middle of the strip because that is where it landed, between a half-built lounge and the structural work that finished it.

| Phase | When | Entity and seat | What was built |
|---|---|---|---|
| Mural | 2013 | Carroll Shelby International; Tellus as general contractor | The signature, the insignia and the racing stripes on the road-facing wall |
| Retail store | 2013 to 2014 | Carroll Shelby International; Tellus as general contractor | The museum store, open for business |
| Las Vegas relocation | October 2014 to March 2015 | Shelby American; Tellus as owner's representative | The move to a new Las Vegas property, told in its own report |
| Snake Pit, first phase | 2015 to 2016 | Carroll Shelby International; Tellus as general contractor | Models of the building, the museum and the lounge on display; temporary walls showing the visitor flow; the lounge half built by August 2016 |
| Snake Pit, second phase | January 2017 to spring 2017 | Carroll Shelby International; Tellus as general contractor | Structural modifications, roll-up door systems, finishes, the bar in the apartment, a commercial kitchen and event space |
The client's own words, in the release Tellus issued in January 2017: "The Tellus Design Build team earned our trust, and reflects Carroll Shelby's, and America's, true spirit of competition and hard work," from M. Neil Cummings, Esq., Co-CEO of Carroll Shelby International, Inc. A client statement inside the contractor's own release is the weakest form of proof, and I would not lean on it. The phases are the proof. A client does not come back three times for a contractor it has stopped trusting, and it does not hand that contractor the part of the building where its namesake lived.
What we kept, and what we installed
Nothing was installed at the client. The foundation kept its own calendar and released each phase when it was ready to, and a contractor who tries to install a program on a client like that is installing a pitch.
Two things were installed at Tellus, and both are still in use.
The first is the rule that every phase is bid on its own. It was already an instinct; Shelby made it a rule, because it worked on the hardest possible test, a famous client who could have hired anyone. The faulty logic it replaced is the master agreement: a locked rate and a default to the incumbent that protects the contractor's forward revenue by taking the client's freedom to walk. The client can feel that, and the feeling is what a program bid is priced against.
The second is the value-to-the-city packet. I put it in during the freeze, in 2016, because the ordinary method was unusable: there was no form to file and no exception to ask for. What was wrong in the original logic was the assumption that a rule is decided by its text. It is decided by a person, and the person needs a reason the exception serves the city and a record they can check without taking anyone's word. Costa Mesa got the same treatment later on a different problem, the first use permit for an axe-throwing venue in a city whose code had no line for one, and there the order was reversed on purpose: prove the use first by running it, then file with the running venue as the evidence. The packet is the same. What changes is what you are allowed to do before you ask.
That is the limit on the mural rule, and it is worth stating plainly. Forgiveness works when the finished fact is better than the request would have sounded and the cost of being wrong is a coat of paint. It does not work where the thing being decided is safety or use, or where the reviewer's exposure is bigger than yours. A wall can be repainted. A use with a life-safety finding cannot be forgiven after the fact, and a freeze that a council has announced to everyone is not going to be undone by a finished thing on the street. In those cases the finished fact is still the strongest argument you have; it just has to be brought in with the paper behind it and a person to answer for it. The method note attached to this report lays the three cases side by side.
What it cost to hold the line, and what I would watch
Pricing the wall cost forward visibility. For four years there was no signed program, no locked rate and no phase that could not have been rebid to another contractor, including the structural phase, where a bigger firm with more standing could have pitched the whole museum as a package. Every phase we won, we won again. The mural cost a bet: the downside of painting first was a repaint and a bad first impression with the city on a client's building, and that downside was real, not theoretical. The freeze cost weeks of my own time in the middle of a busy year, assembling a record and standing in a room where no one owed us a yes.
What I would watch on a relationship like this one is three things. Structural work inside an occupied legacy space, because the thing you are cutting into is the reason the client cares, and the site knowledge you have built across the earlier phases is the only thing that keeps that from going wrong. The client's own calendar, because a foundation's phases release on its cycle and not on yours, and the temptation to pull the next phase forward is the same temptation as the program bid. And the line between what can be forgiven and what has to be asked. The mural was on the right side of it. Anyone who takes the mural as the whole lesson, and paints first on a use or a structure, has learned the wrong half.
What transfers out of this one is not construction. It is the shape of a relationship with a counterparty that has every reason to be careful: a famous client with no history with you, a city with a rule and no form. In both cases the ask that works is the one sized to what you have already put in front of them, and the thing that earns the next ask is the last one finished well. I have run vendor relationships, city approvals and buy-side conversations on that rule since, and the failure I watch for is always the same one, the program sold before the wall is dry.
Questions answered
Snake Pit VIP Lounge and Event Space
When demolition revealed the barrel ceiling and you proposed making it the centerpiece, how did you get the client comfortable with that pivot while protecting the schedule and budget?
We didn't really need to. The key was preliminary demolition, and it's a practice I believe in. A lot of contractors keep the walls closed on a renovation, because whatever they find opens them up to change orders. I'd rather know. It takes very little: cut a couple of quick holes, look, patch them. You see how the wall is put together, how the structure ties in, what the hold-downs look like, and here, what the ceiling looked like. We did that on the Shelby project before the plan was approved, not after. So the pivot came early and it was easy. The second everyone saw that barrel ceiling, we were all in agreement.
Answered 2026-09-29.
How did that phase-by-phase structure change the way you managed the work and earned the next award: particularly with the client's trust and ability to say no each time?
We had a long history with Shelby: the retail store, their building, then the owner's rep work in Las Vegas, so honestly it was our work to lose. We never asked for a master agreement. Every phase was bid on its own, so they could say no after any of them, and every success compounded on the next. A lot of it was documentation and communication. Something always goes wrong in construction, but if you say what's going to happen and document it well, you're okay, and we did that well.
Answered 2026-09-29 (first dictated; finalized 2026-09-30).
Gardena Retail Store Build-Out
Walk me through one specific site or sequencing decision you made to control the dust, noise, or crew access, and what constraint drove that decision?
The store sat in a far corner of the lot, which helped, and we did two things. The one door into the garage where very expensive cars were stored, we didn't just tape plastic over. We built a temporary sealed wall across it. The employees in the small office above, we moved to open space in the Shelby Building a few hundred yards away, then walled that section off too. Plastic lets dust creep into everything. A sealed temporary wall is the better answer whenever you can build one.
Answered 2026-09-29.
To make the impact more concrete, what was the planned and actual duration of the build-out, and did you hit the target opening date?
It was a race. The client came to us maybe four months before the annual Carroll Shelby car show, and the show was held at the site, so that date was the deadline. We did the buildout in 60 days, start to finish, and the store was ready for the show. Stocking it was the easy part. Shelby's name is on so many things that filling the store with product took care of itself. The hard part was getting the buildout done in time.
Answered 2026-09-29.
After the 60-day store delivery, what specifically did Carroll Shelby International see in your execution that gave them enough confidence to award the next phase?
Honestly, the store alone didn't win the next phase. By then we'd done so much work for them that these were our projects to lose. It was the whole body of work that earned it.
Answered 2026-09-29 (first dictated; finalized 2026-09-30).
What did you have to coordinate or decide to build that store inside a working licensing office and have it ready for the annual car show?" (asked on the mural card; answered on the store card per F2)
We designed and built that store inside a working licensing office, so we were coordinating around all their employees, all their cars and the desks upstairs. They had a lot of their really expensive cars in the adjacent space. Any time you're moving people and expensive vehicles, and working around those vehicles with your crews or subcontractors, there's an extra layer of risk and protection required.
Answered 2026-10-03.
Gardena Mural Installation
What had to go right in the actual execution, such as preparing the wall, laying out the stripes and insignia, or making the finish durable, for the completed mural to persuade people who had never seen a proposal?
Getting his signature right at full scale was the whole job, and I had a really outstanding artist to do it. The brief was the Shelby insignia, blue racing stripes and Carroll Shelby's own signature. We laid it out at night. We set an outdoor projector on the lot and threw his signature, massive, onto one side of the building and the Shelby insignia onto the other. The artist went up a ladder, penciled along the projection, then filled it in. It was a big prep ordeal and more work than the price assumed, but it was fun, and the finished wall is what the city saw before it told us to keep it up.
Answered 2026-09-29.
What was the hardest delivery constraint in that 60-day build, and what specific decision or coordination move made the store ready for the event?
The mural wasn't part of the 60-day build. It was separate, with no deadline, and it was basically a single trade: a couple of painters and artists. It wasn't a big assembly line, and it wasn't high risk.
Answered 2026-09-29 (first dictated; finalized 2026-09-30).
What did you have to coordinate or decide to build that store inside a working licensing office and have it ready for the annual car show?
That store was its own project. For the mural, we laid out his signature at night with an outdoor projector, and once the city saw the finished wall, they told us to keep it up.
Answered 2026-10-03.
At that scale, how did you keep the projected signature accurate while the artist worked from a ladder, and what quality check told you the finished image was ready for the city to see?
Tracing straight off the projection is what kept it accurate at full size. Knowing it was ready was like any piece of art. It was our call, made by visual inspection, and we had to make some tweaks, but it was strictly looking at it and deciding if it was right.
Answered 2026-10-03.
Flagship Retail and Visitor Facility Delivery
How did you manage that compressed build without disrupting the licensing operation?
It was a race. The annual Carroll Shelby car show was at the site, so the buildout had to be done in 60 days, start to finish. The store sat on one corner of the lot, with employees in a small office above it. We moved those employees over to the Shelby Building, which had plenty of room, and walled that section off. One door opened into a garage full of very expensive cars, so we didn't just put plastic over it, we built a temporary wall across it. Sealed temporary walls beat plastic dust control, because dust gets into everything.
Answered 2026-09-29.
